What are Procore's standard budget views?
Answer
In Procore, a budget view is a visual layout for your budget data. Using Procore's budget view feature in the Company Admin tool (see Set up a New Budget View), you can create customized views of your construction project's budget. You can also use one of the default budget view templates that are available by default.
Procore Standard Budget View
Procore Standard Budget (Custom Reporting View)
Blank Budget View
(Multi-Level) Procore Standard Budget View
Procore Labor Productivity Cost View
Procore Standard Budget View
All Procore company accounts include the 'Procore Standard Budget' view, which is the default view that is available for use with the project's Budget tool. This view can also be customized as described in Set up a New Budget View.

ExampleProcore Standard Budget View
The illustration below shows you the default layout for the 'Procore Standard Budget' view, as it looks when assigned to a project's Budget tool.

Default Columns
The following table details the default column and layout of the 'Procore Standard Budget' view.
Column Name
Column Type
Column Format
Description
Description
Standard
n/a
Shows the project's budget code and budget code description. Depending on your budget code, this shows the division, cost code, and cost type associated with the budget line item. If sub jobs are enabled in Procore (see Enable Sub Jobs on Projects for WBS), this column shows the name of the sub job associated with the budget line item.
Original Budget Amount
Standard
Currency
Shows the original budget amount for the budget line item.
Approved COs
Source
n/a
This visible column shows the commitment change orders in the Approved status by default. It also provides advanced options that permit you to include/exclude change orders in other statuses and Prime Contract. This column is also used to calculate the 'Forecast to Complete' value in the budget line item.
Revised Budget
Calculated
Currency
This visible column shows the total amount of any Budget Modifications + Approved COs. This column is also used to calculate the 'Forecast to Complete' value in the budget line item.
Pending Budget Changes
Source
Currency
This visible column shows the amounts from pending prime contract change orders in the Pending - statuses for the budget line item.
Projected Budget
Calculated
Currency
This visible column Calculates the value of the Revised Budget + Pending Budget Changes values. It also includes a subtotals and grandtotals.
Committed Costs 2
Source
Currency
This visible column shows the commitment costs for subcontracts in the Approved and Complete statuses, purchase orders in the Approved status, and change orders in the Approved status. It also provides advanced options that permit you to include/exclude other status options for commitments and change orders.
Direct Costs
Source
Currency
This visible column shows direct costs in the Pending, Revise and Resubmit, and Approved status.
Job to Date Costs
Calculated
Currency
This visible column shows Direct Costs + Subcontractor Invoices.
Pending Cost Changes 1
Source
Currency
This visible column shows subcontracts in the Out for Signature status, purchase order contracts in the Processing, Submitted, Partially Received, and Received Status, and change orders in the Pending - statuses.
Projected Costs 1
Calculated
Currency
This visible column shows Committed Costs + Direct Costs + Pending Cost Changes.This column is also used to calculate the 'Forecast to Complete' value in the budget line item.
Forecast to Complete
Standard
Currency
This visible column is an automatic calculation of the Projected Budget - Project Costs.
Estimated Cost at Completion
Calculated
Currency
This visible column calculates the Projected Costs + Forecast to Complete.
Projected Over/Under
Calculated
Currency
This visible column calculates the Projected Budget - Estimated Cost at Completion.
Budget ROM
Source
Currency
Shows the budget's Rough Order of Magnitude (ROM) value.
Budget Changes 1
Standard
Currency
Shows the amount of a budget change for the budget line item.
Revised Budget (+Changes)
Calculated
Currency
Calculates a value for the Original Budget Amount + Budget Changes.
Projected Cost Budget
Calculated
Currency
Calculates a value of the Original Budget Amount + Budget ROM + Budget Changes.
1 The Budget Changes column requires users to migrate their data to the new Budget Changes feature. See Migrating to Budget Changes from Budget Modifications.
2 This column reflects contract values from Procore's Commitments tool. However, the commitment must be set to a specific status. To learn more, see What are the default commitment statuses in Procore?
Procore Standard Budget View
The illustration below shows you the default layout for the 'Procore Standard Budget' view, as it looks when assigned to a project's Budget tool.
Default Columns
The following table details the default column and layout of the 'Procore Standard Budget' view.
Column Name | Column Type | Column Format | Description |
---|---|---|---|
Description | Standard | n/a | Shows the project's budget code and budget code description. Depending on your budget code, this shows the division, cost code, and cost type associated with the budget line item. If sub jobs are enabled in Procore (see Enable Sub Jobs on Projects for WBS), this column shows the name of the sub job associated with the budget line item. |
Original Budget Amount | Standard | Currency | Shows the original budget amount for the budget line item. |
Approved COs | Source | n/a | This visible column shows the commitment change orders in the Approved status by default. It also provides advanced options that permit you to include/exclude change orders in other statuses and Prime Contract. This column is also used to calculate the 'Forecast to Complete' value in the budget line item. |
Revised Budget | Calculated | Currency | This visible column shows the total amount of any Budget Modifications + Approved COs. This column is also used to calculate the 'Forecast to Complete' value in the budget line item. |
Pending Budget Changes | Source | Currency | This visible column shows the amounts from pending prime contract change orders in the Pending - statuses for the budget line item. |
Projected Budget | Calculated | Currency | This visible column Calculates the value of the Revised Budget + Pending Budget Changes values. It also includes a subtotals and grandtotals. |
Committed Costs 2 | Source | Currency | This visible column shows the commitment costs for subcontracts in the Approved and Complete statuses, purchase orders in the Approved status, and change orders in the Approved status. It also provides advanced options that permit you to include/exclude other status options for commitments and change orders. |
Direct Costs | Source | Currency | This visible column shows direct costs in the Pending, Revise and Resubmit, and Approved status. |
Job to Date Costs | Calculated | Currency | This visible column shows Direct Costs + Subcontractor Invoices. |
Pending Cost Changes 1 | Source | Currency | This visible column shows subcontracts in the Out for Signature status, purchase order contracts in the Processing, Submitted, Partially Received, and Received Status, and change orders in the Pending - statuses. |
Projected Costs 1 | Calculated | Currency | This visible column shows Committed Costs + Direct Costs + Pending Cost Changes.This column is also used to calculate the 'Forecast to Complete' value in the budget line item. |
Forecast to Complete | Standard | Currency | This visible column is an automatic calculation of the Projected Budget - Project Costs. |
Estimated Cost at Completion | Calculated | Currency | This visible column calculates the Projected Costs + Forecast to Complete. |
Projected Over/Under | Calculated | Currency | This visible column calculates the Projected Budget - Estimated Cost at Completion. |
Budget ROM | Source | Currency | Shows the budget's Rough Order of Magnitude (ROM) value. |
Budget Changes 1 | Standard | Currency | Shows the amount of a budget change for the budget line item. |
Revised Budget (+Changes) | Calculated | Currency | Calculates a value for the Original Budget Amount + Budget Changes. |
Projected Cost Budget | Calculated | Currency | Calculates a value of the Original Budget Amount + Budget ROM + Budget Changes. |
1 The Budget Changes column requires users to migrate their data to the new Budget Changes feature. See Migrating to Budget Changes from Budget Modifications.
2 This column reflects contract values from Procore's Commitments tool. However, the commitment must be set to a specific status. To learn more, see What are the default commitment statuses in Procore?
Procore Standard Budget (Custom Reporting View)
By default, the columns in the 'Procore Standard Budget (Custom Reporting View)' exactly matches the columns in the 'Procore Standard Budget' view. You can use this view to create a customized budget view to use as a source for generating custom reports with the Company and Project level Reports tool. To learn how to set up a budget view for custom reporting, see Set Up a Budget View for Custom Reporting.
ExampleProcore Standard Budget (Custom Reporting View)
The illustration below shows you the default layout for the 'Procore Standard Budget (Custom Reporting View)', as it looks when assigned to a project's Budget tool.

Default Columns
The following table details the default column and layout of the 'Procore Standard Budget (Custom Reporting View).'
Column Name
Column Type
Column Format
Description
Sub Job
Standard
n/a
If sub jobs are enabled in Procore, this column shows the name of the sub job associated with the budget line item.
Division
Standard
n/a
Shows the division associated with the budget line item.
Cost Code
Standard
n/a
Shows the cost code associated with the budget line item.
Cost Type
Standard
n/a
Shows the cost type associated with the budget line item.
Original Budget Amount
Standard
Currency
Shows the original budget amount for the budget line item.
Budget Modifications
Standard
Currency
Shows the amount of a budget modification for the budget line item.
Approved COs
Source
n/a
Shows the Prime Contract Change Orders in the Approved status by default. It also provides advanced options that permit you to include/exclude change orders in other statuses and Prime Contracts. This column is also used to calculate the 'Forecast to Complete' value in the budget line item.
Revised Budget
Calculated
Currency
Shows the total amount of any Budget Modifications + Approved COs. This column is also used to calculate the 'Forecast to Complete' value in the budget line item.
Pending Budget
Source
Currency
Shows the all budget changes in the Pending - statuses for the budget line item.
Committed Costs
Source
Currency
Shows the commitment costs for subcontracts in the Approved and Complete statuses, purchase orders in the Approved status, and change orders in the Approved status. It also provides advanced options that permit you to include/exclude other status options for commitments and change orders.
Direct Costs
Source
Currency
Shows direct costs in the Pending, Revise and Resubmit, and Approved status.
Job to Date Costs
Calculated
Currency
Shows Direct Costs + Subcontractor Invoices.
Pending Cost Changes
Source
Currency
Shows subcontracts in the Out for Signature status, purchase order contracts in the Processing, Submitted, Partially Received, and Received Status, and change orders in the Pending - statuses.
Projected Costs
Calculated
Currency
Shows Committed Costs + Direct Costs + Pending Cost Changes.This column is also used to calculate the 'Forecast to Complete' value in the budget line item.
Forecast to Complete
Standard
Currency
Shows an automatic calculation of the Projected Budget - Project Costs.
Estimated Cost at Completion
Calculated
Currency
Calculates the Projected Costs + Forecast to Complete.
Projected Over/Under
Calculated
Currency
Calculates the Projected Budget - Estimated Cost at Completion.
Procore Standard Budget (Custom Reporting View)
The illustration below shows you the default layout for the 'Procore Standard Budget (Custom Reporting View)', as it looks when assigned to a project's Budget tool.
Default Columns
The following table details the default column and layout of the 'Procore Standard Budget (Custom Reporting View).'
Column Name | Column Type | Column Format | Description |
---|---|---|---|
Sub Job | Standard | n/a | If sub jobs are enabled in Procore, this column shows the name of the sub job associated with the budget line item. |
Division | Standard | n/a | Shows the division associated with the budget line item. |
Cost Code | Standard | n/a | Shows the cost code associated with the budget line item. |
Cost Type | Standard | n/a | Shows the cost type associated with the budget line item. |
Original Budget Amount | Standard | Currency | Shows the original budget amount for the budget line item. |
Budget Modifications | Standard | Currency | Shows the amount of a budget modification for the budget line item. |
Approved COs | Source | n/a | Shows the Prime Contract Change Orders in the Approved status by default. It also provides advanced options that permit you to include/exclude change orders in other statuses and Prime Contracts. This column is also used to calculate the 'Forecast to Complete' value in the budget line item. |
Revised Budget | Calculated | Currency | Shows the total amount of any Budget Modifications + Approved COs. This column is also used to calculate the 'Forecast to Complete' value in the budget line item. |
Pending Budget | Source | Currency | Shows the all budget changes in the Pending - statuses for the budget line item. |
Committed Costs | Source | Currency | Shows the commitment costs for subcontracts in the Approved and Complete statuses, purchase orders in the Approved status, and change orders in the Approved status. It also provides advanced options that permit you to include/exclude other status options for commitments and change orders. |
Direct Costs | Source | Currency | Shows direct costs in the Pending, Revise and Resubmit, and Approved status. |
Job to Date Costs | Calculated | Currency | Shows Direct Costs + Subcontractor Invoices. |
Pending Cost Changes | Source | Currency | Shows subcontracts in the Out for Signature status, purchase order contracts in the Processing, Submitted, Partially Received, and Received Status, and change orders in the Pending - statuses. |
Projected Costs | Calculated | Currency | Shows Committed Costs + Direct Costs + Pending Cost Changes.This column is also used to calculate the 'Forecast to Complete' value in the budget line item. |
Forecast to Complete | Standard | Currency | Shows an automatic calculation of the Projected Budget - Project Costs. |
Estimated Cost at Completion | Calculated | Currency | Calculates the Projected Costs + Forecast to Complete. |
Projected Over/Under | Calculated | Currency | Calculates the Projected Budget - Estimated Cost at Completion. |
Blank Budget View
The Blank Budget View provides you with a basic set of budget columns to manage a simple budget.

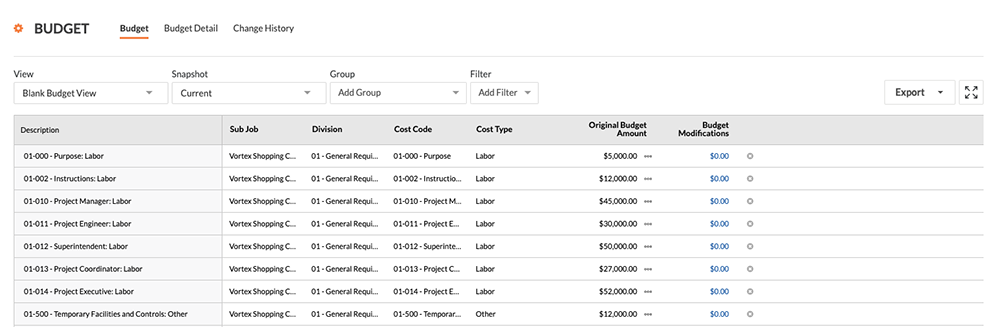

ExampleBlank Budget View
The illustration below shows you the default layout for the 'Blank Budget View', as it looks when assigned to a project's Budget tool.

Default Columns
The following table details the default column and layout of the 'Blank Budget View.'
Column Name
Column Type
Column Format
Description
Sub Job
Standard
n/a
If sub jobs are enabled in Procore (see Enable Sub Jobs on Projects for WBS), this column shows the name of the sub job associated with the budget line item.
Division
Standard
n/a
Shows the division associated with the budget line item.
Cost Code
Standard
n/a
Shows the cost code associated with the budget line item.
Cost Type
Standard
n/a
Shows the cost type associated with the budget line item.
Budget Unit Qty
Standard
n/a
Shows the unit quantity for the budget line item.
Budget UOM
Standard
n/a
Shows the UOM for the budget line item
Budget Unit Cost
Standard
n/a
Shows the unit cost for the budget line item.
Original Budget Amount
Standard
n/a
Shows the original budget amount for the budget line item.
Budget Modifications
Standard
n/a
Shows the amount of a budget modification for the budget line item.
Blank Budget View
The illustration below shows you the default layout for the 'Blank Budget View', as it looks when assigned to a project's Budget tool.
Default Columns
The following table details the default column and layout of the 'Blank Budget View.'
Column Name | Column Type | Column Format | Description |
---|---|---|---|
Sub Job | Standard | n/a | If sub jobs are enabled in Procore (see Enable Sub Jobs on Projects for WBS), this column shows the name of the sub job associated with the budget line item. |
Division | Standard | n/a | Shows the division associated with the budget line item. |
Cost Code | Standard | n/a | Shows the cost code associated with the budget line item. |
Cost Type | Standard | n/a | Shows the cost type associated with the budget line item. |
Budget Unit Qty | Standard | n/a | Shows the unit quantity for the budget line item. |
Budget UOM | Standard | n/a | Shows the UOM for the budget line item |
Budget Unit Cost | Standard | n/a | Shows the unit cost for the budget line item. |
Original Budget Amount | Standard | n/a | Shows the original budget amount for the budget line item. |
Budget Modifications | Standard | n/a | Shows the amount of a budget modification for the budget line item. |
(Multi-Level) Procore Standard Budget View
This budget view provides users with a multi-level cost code structure. This view can also be customized as described in Set up a New Budget View.

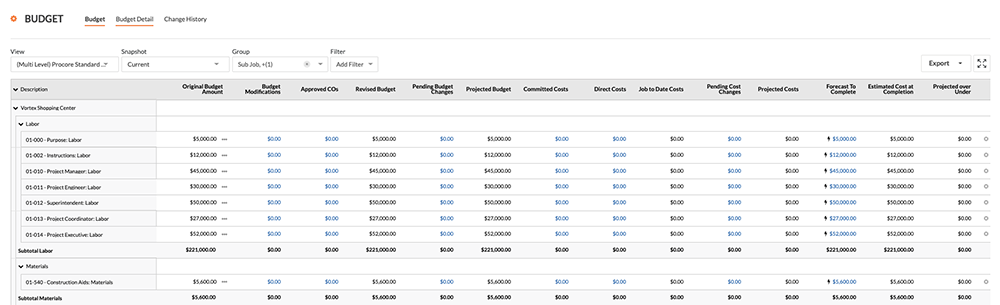

Example(Multi-Level) Procore Standard Budget View
The illustration below shows you the default layout for the '(Multi-Level) Procore Standard Budget View', as it looks when assigned to a project's Budget tool. It also shows your budget when grouped by Sub Job and Cost Type.

Default Columns
The following table details the default column and layout of the '(Multi-Level) Procore Standard Budget View.'
Column Name
Column Type
Column Format
Description
Cost Code Level 1
Standard
n/a
This column shows the first level of the multi-level cost code associated with the budget line item.
Cost Code Level 2
Standard
n/a
This column shows the second level of the multi-level cost code associated with the budget line item.
Cost Code Level 3
Standard
n/a
This column shows the third level of the multi-level cost code associated with the budget line item.
Cost Code Level 4
Standard
n/a
This column shows the fourth level of the multi-level cost code associated with the budget line item.
Cost Code Level 5
Standard
n/a
This column shows the fifth level of the multi-level cost code associated with the budget line item.
Cost Type
Standard
n/a
This visible column shows the cost type associated with the budget line item.
Budget Unit Qty
Standard
n/a
Shows the unit quantity for the budget line item.
Budget UOM
Standard
n/a
Shows the UOM for the budget line item
Budget Unit Cost
Standard
n/a
Shows the unit cost for the budget line item.
Original Budget Amount
Standard
n/a
Shows the original budget amount for the budget line item.
Budget Modifications
Standard
n/a
Shows the amount of a budget modification for the budget line item.
Project
Standard
n/a
Shows the name of the project.
Sub Job
Standard
n/a
If sub jobs are enabled in Procore, this column shows the name of the sub job associated with the budget line item.
Forecast to Complete
Standard
n/a
Shows an automatic calculation of the Projected Budget - Project Costs.
(Multi-Level) Procore Standard Budget View
The illustration below shows you the default layout for the '(Multi-Level) Procore Standard Budget View', as it looks when assigned to a project's Budget tool. It also shows your budget when grouped by Sub Job and Cost Type.
Default Columns
The following table details the default column and layout of the '(Multi-Level) Procore Standard Budget View.'
Column Name | Column Type | Column Format | Description |
---|---|---|---|
Cost Code Level 1 | Standard | n/a | This column shows the first level of the multi-level cost code associated with the budget line item. |
Cost Code Level 2 | Standard | n/a | This column shows the second level of the multi-level cost code associated with the budget line item. |
Cost Code Level 3 | Standard | n/a | This column shows the third level of the multi-level cost code associated with the budget line item. |
Cost Code Level 4 | Standard | n/a | This column shows the fourth level of the multi-level cost code associated with the budget line item. |
Cost Code Level 5 | Standard | n/a | This column shows the fifth level of the multi-level cost code associated with the budget line item. |
Cost Type | Standard | n/a | This visible column shows the cost type associated with the budget line item. |
Budget Unit Qty | Standard | n/a | Shows the unit quantity for the budget line item. |
Budget UOM | Standard | n/a | Shows the UOM for the budget line item |
Budget Unit Cost | Standard | n/a | Shows the unit cost for the budget line item. |
Original Budget Amount | Standard | n/a | Shows the original budget amount for the budget line item. |
Budget Modifications | Standard | n/a | Shows the amount of a budget modification for the budget line item. |
Project | Standard | n/a | Shows the name of the project. |
Sub Job | Standard | n/a | If sub jobs are enabled in Procore, this column shows the name of the sub job associated with the budget line item. |
Forecast to Complete | Standard | n/a | Shows an automatic calculation of the Projected Budget - Project Costs. |
Non-Budgeted Source View
All Procore company accounts include the 'Non-Budgeted Source View.' This view helps you identify non-budgeted items in a projects by showing contracts, change orders, direct costs, and change events. This view can also be customized as described in Set up a New Budget View.

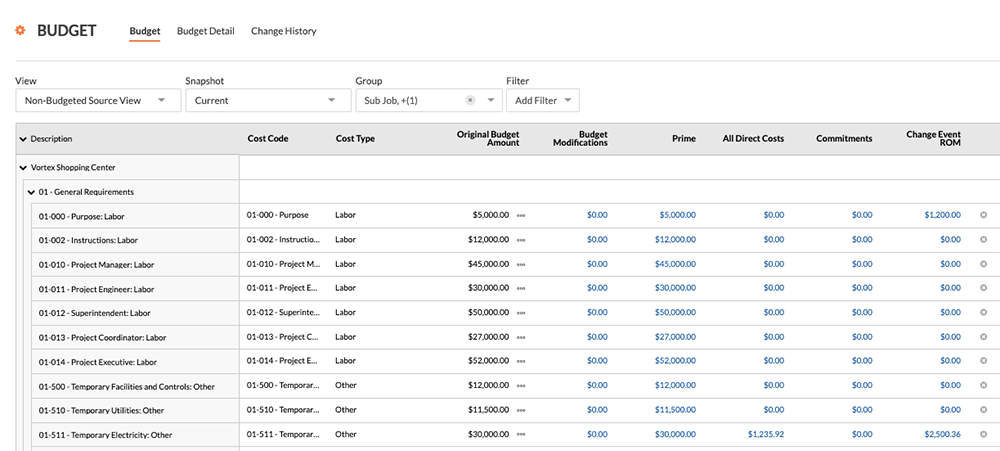

ExampleNon-Budgeted Source View
The illustration below shows you the default layout for the 'Non-Budgeted Source View,' as it looks when assigned to a project's Budget tool. It also shows your budget grouped by Sub Job and Division.

Default Columns
The following table details the default column and layout of the 'Non-Budgeted Source View.'
Column Name
Column Type
Column Format
Description
Sub Job
Standard
n/a
If sub jobs are enabled in Procore, this column shows the name of the sub job associated with the budget line item.
Division
Standard
n/a
Shows the division associated with the budget line item.
Cost Code
Standard
n/a
Shows the cost code associated with the budget line item.
Cost Type
Standard
n/a
Shows the cost type associated with the budget line item.
Budget Unit Qty
Standard
n/a
Shows the unit quantity for the budget line item.
Budget UOM
Standard
n/a
Shows the UOM for the budget line item
Budget Unit Cost
Standard
n/a
Shows the unit cost for the budget line item.
Original Budget Amount
Standard
Currency
This visible column shows the original budget amount for the budget line item.
Budget Modifications
Standard
Currency
This visible column shows the amount of a budget modification for the budget line item.
Project
Standard
n/a
This hidden columns provides the project information.
Prime
Source
Currency
This visible column shows prime contracts and prime contract change orders associated with the budget line item.
All Direct Costs
Source
Currency
This visible column shows all of the direct costs associated with the budget line item.
Commitments
Source
Currency
This visible column shows the purchase orders and subcontractors associated with the budget line item.
Change Event ROM
Source
currency
This visible column shows the estimated Rough Order of Magnitude (ROM) value for any change events associated with the budget line item.
Non-Budgeted Source View
The illustration below shows you the default layout for the 'Non-Budgeted Source View,' as it looks when assigned to a project's Budget tool. It also shows your budget grouped by Sub Job and Division.
Default Columns
The following table details the default column and layout of the 'Non-Budgeted Source View.'
Column Name | Column Type | Column Format | Description |
---|---|---|---|
Sub Job | Standard | n/a | If sub jobs are enabled in Procore, this column shows the name of the sub job associated with the budget line item. |
Division | Standard | n/a | Shows the division associated with the budget line item. |
Cost Code | Standard | n/a | Shows the cost code associated with the budget line item. |
Cost Type | Standard | n/a | Shows the cost type associated with the budget line item. |
Budget Unit Qty | Standard | n/a | Shows the unit quantity for the budget line item. |
Budget UOM | Standard | n/a | Shows the UOM for the budget line item |
Budget Unit Cost | Standard | n/a | Shows the unit cost for the budget line item. |
Original Budget Amount | Standard | Currency | This visible column shows the original budget amount for the budget line item. |
Budget Modifications | Standard | Currency | This visible column shows the amount of a budget modification for the budget line item. |
Project | Standard | n/a | This hidden columns provides the project information. |
Prime | Source | Currency | This visible column shows prime contracts and prime contract change orders associated with the budget line item. |
All Direct Costs | Source | Currency | This visible column shows all of the direct costs associated with the budget line item. |
Commitments | Source | Currency | This visible column shows the purchase orders and subcontractors associated with the budget line item. |
Change Event ROM | Source | currency | This visible column shows the estimated Rough Order of Magnitude (ROM) value for any change events associated with the budget line item. |
Procore Labor Productivity Cost View
The 'Procore Labor Productivity Cost' budget view provides project teams with the ability to include production quantities on the project's budget. See What are 'production quantities'? Building off the Real-Time Labor Costing feature, the 'Procore Labor Productivity Cost' budget view is designed to provide self-performing and specialty contractors with the ability to gain greater insight into your project's production rates to make better decisions that maximize profit margins. With this release, you can:
Add and import production units to a project's budget in Procore's Financial Management tools: Budget, Change Events, and Change Orders.
Collect production units from field personnel with Timecard Entries in the Daily Log and both the Timecards and Timesheets tools.
Track and compare budgeted production units to installed production units using Procore's Budget and Reports tools.
By default, Procore provides its users with a standard 'Procore Labor Productivity Cost' budget view, which is available to your company's Procore Administrator in the Company level Admin tool.
ExampleProcore Labor Productivity Cost Budget View in the Budget Tool
The illustration below shows you the recommended layout for the 'Procore Labor Productivity Cost' budget view, as it will look when applied to your project's Budget tool.

Default Columns
The following table details the default columns provided with the 'Procore Labor Productivity Cost' budget view. In the Description column, the following symbols represent the operator for a calculation:
add (+)
subtract (-)
multiply (*)
divide (/)
Column Name
Column Type
Column Format
Column Description
Column Configuration
Revised Budget
Calculated
Currency
Shows the Original Budget amount, plus the Budget Change amount, plus the Approved COs amount.
Original Budget Add (+) Budget Changes Add (+) Approved COs
Direct Costs
Source
Currency
Shows the Direct Costs amount.
Source Category: Direct Costs Source: Direct Costs Source Filtering: Status = Pending, Revise and Resubmit, Approved
Direct Costs Unit Cost
Source
Number
Shows the actual cost per unit for direct costs.
Direct Costs Divide (/) Direct Costs Unit Qty
% Budget Complete
Calculated
Percent
Shows how much of the current budget amount for the budget line item is estimated to be used based on the real-time labor hours and actual labor cost.
Estimated Cost w/ Timesheet Hours Divide (/) Revised Budget
Projected Labor Cost at Completion
Calculated
Currency
Shows the projected labor cost at completion for the budget line item.
Projected Hours at Completion Multiply (*) Direct Costs Unit Cost
Projected Labor Cost Over/Under
Calculated
Current
Shows the Revised Budget minus the Projected Labor Cost at Completion.
Revised Budget Subtract (-) Project Labor Cost at Completion
Revised Budgeted Unit Qty
Calculated
Number
Shows the Budget Production Qty plus the Approved COs Production Qty.
Budget Unit Qty Add (+) Approved CO Units
Budget UOM
Standard
n/a
Shows the Unit of Measure (UOM) for the budget line item.
n/a
Timesheet Hours 1
Source
Number
Shows all Timecard Entry Hours. You can optionally apply Status filters to narrow the data in the view.
Source Category: Timecard Entry Hours Source: Timecard Entry Hours Filtering: None
% Hours Used
Calculated
Percent
Shows how much of the current budget unit qty (labor hours) have been used based on time submitted in Procore.
Timesheet Hours Divide (/) Revised Budget Unit Qty
Earned Hours
Calculated
Number
Shows the number of labor hours earned (merited) based on the work produced to date for that cost code.
Revised Budget Unit Quantity Multiply (*) % Complete Production
Projected Hours at Completion
Calculated
Number
Shows the estimated labor hours needed to complete production for the cost code based on the work produced to date.
Timesheet Hours Divide (/) % Complete Production
% Complete Production
Calculated
Percent
Shows the percentage of the production quantity has been installed to date of the current budgeted production quantity for the cost code.
Actual Qty Installed Divide (/) Revised Budgeted Production Qty
Production UOM
Source
n/a
Shows the UOM for the budgeted production quantity (i.e., for the cost code on the line item).
Source Category: Production UOM Source: Budgeted Production UOM Source Filtering: n/a
Revised Budgeted Production Rate
Calculated
Number
Shows the actual budgeted production rate based on labor hours and installed quantities to date.
Revised Budgeted Production Qty Divide (/) Revised Budget Unit Qty
Actual Production Rate
Calculated
Number
Shows the actual budgeted production rate based on labor hours and installed quantities to date.
Actual Qty Installed Divide (/) Timesheet Hours
Variance Production Rate
Calculated
Number
Shows the difference between the current budgeted production rate and the actual production rate. A positive number indicates you are performing faster than expected. A negative number indicates you are performing slower than expected.
Actual Production Rate Subtract (-) Revised Budgeted Production Rate
1 The 'Labor Productivity Cost' budget view is only available to customers using Procore's Resource Tracking tools. However, the 'Timesheet Hours' column can be added to other budget views. To learn how to add the column, see Can we import our third-party timecard entries to work with the 'Timesheet Hours' column in Procore's Budget tool?
Procore Labor Productivity Cost Budget View in the Budget Tool
The illustration below shows you the recommended layout for the 'Procore Labor Productivity Cost' budget view, as it will look when applied to your project's Budget tool.
Default Columns
The following table details the default columns provided with the 'Procore Labor Productivity Cost' budget view. In the Description column, the following symbols represent the operator for a calculation:
add (+)
subtract (-)
multiply (*)
divide (/)
Column Name | Column Type | Column Format | Column Description | Column Configuration |
---|---|---|---|---|
Revised Budget | Calculated | Currency | Shows the Original Budget amount, plus the Budget Change amount, plus the Approved COs amount. | Original Budget Add (+) Budget Changes Add (+) Approved COs |
Direct Costs | Source | Currency | Shows the Direct Costs amount. | Source Category: Direct Costs Source: Direct Costs Source Filtering: Status = Pending, Revise and Resubmit, Approved |
Direct Costs Unit Cost | Source | Number | Shows the actual cost per unit for direct costs. | Direct Costs Divide (/) Direct Costs Unit Qty |
% Budget Complete | Calculated | Percent | Shows how much of the current budget amount for the budget line item is estimated to be used based on the real-time labor hours and actual labor cost. | Estimated Cost w/ Timesheet Hours Divide (/) Revised Budget |
Projected Labor Cost at Completion | Calculated | Currency | Shows the projected labor cost at completion for the budget line item. | Projected Hours at Completion Multiply (*) Direct Costs Unit Cost |
Projected Labor Cost Over/Under | Calculated | Current | Shows the Revised Budget minus the Projected Labor Cost at Completion. | Revised Budget Subtract (-) Project Labor Cost at Completion |
Revised Budgeted Unit Qty | Calculated | Number | Shows the Budget Production Qty plus the Approved COs Production Qty. | Budget Unit Qty Add (+) Approved CO Units |
Budget UOM | Standard | n/a | Shows the Unit of Measure (UOM) for the budget line item. | n/a |
Timesheet Hours 1 | Source | Number | Shows all Timecard Entry Hours. You can optionally apply Status filters to narrow the data in the view. | Source Category: Timecard Entry Hours Source: Timecard Entry Hours Filtering: None |
% Hours Used | Calculated | Percent | Shows how much of the current budget unit qty (labor hours) have been used based on time submitted in Procore. | Timesheet Hours Divide (/) Revised Budget Unit Qty |
Earned Hours | Calculated | Number | Shows the number of labor hours earned (merited) based on the work produced to date for that cost code. | Revised Budget Unit Quantity Multiply (*) % Complete Production |
Projected Hours at Completion | Calculated | Number | Shows the estimated labor hours needed to complete production for the cost code based on the work produced to date. | Timesheet Hours Divide (/) % Complete Production |
% Complete Production | Calculated | Percent | Shows the percentage of the production quantity has been installed to date of the current budgeted production quantity for the cost code. | Actual Qty Installed Divide (/) Revised Budgeted Production Qty |
Production UOM | Source | n/a | Shows the UOM for the budgeted production quantity (i.e., for the cost code on the line item). | Source Category: Production UOM Source: Budgeted Production UOM Source Filtering: n/a |
Revised Budgeted Production Rate | Calculated | Number | Shows the actual budgeted production rate based on labor hours and installed quantities to date. | Revised Budgeted Production Qty Divide (/) Revised Budget Unit Qty |
Actual Production Rate | Calculated | Number | Shows the actual budgeted production rate based on labor hours and installed quantities to date. | Actual Qty Installed Divide (/) Timesheet Hours |
Variance Production Rate | Calculated | Number | Shows the difference between the current budgeted production rate and the actual production rate. A positive number indicates you are performing faster than expected. A negative number indicates you are performing slower than expected. | Actual Production Rate Subtract (-) Revised Budgeted Production Rate |
1 The 'Labor Productivity Cost' budget view is only available to customers using Procore's Resource Tracking tools. However, the 'Timesheet Hours' column can be added to other budget views. To learn how to add the column, see Can we import our third-party timecard entries to work with the 'Timesheet Hours' column in Procore's Budget tool?
