Set Up Submittal Schedule Calculations

Objective

To set up and use submittal schedule calculations to automatically calculate date suggestions for approvers' responses.

Background

Submittal Schedule Calculations is an optional configuration feature that can be enabled for use with the Project level Submittals tool. When enabled on a Procore project, this option analyzes these key dates, which are entered by the creator under Submittal Schedule Information in a submittal package or a submittal item:

  • Required On-Site Date

  • Lead Time

  • Design Team Review Time

  • Internal Review Time

After analyzing the date entries, Procore automatically populates the calculated date values for the end user in the following fields:

  • Planned Return Date

  • Planned Internal Review Completed Date

  • Planned Submit By Date

Based on the calculated date values above, Procore also suggests dates for the following fields:

  • Submitter Due Date

  • Approver Due Date

This helps the submittal creator ensure that submittal packages and items submitted to the review team are approved on schedule.

Things to Consider

  • Required User Permissions:

    • To create a submittal that uses these calculations, 'Standard' level permissions to the Submittals tool.

    • To define the calculations used on the project, 'Admin' level permissions to the Submittals tool.

  • Prerequisite:

  • Additional Information:

    • Schedule calculations do NOT automatically populate due dates in the submittal workflow.

Steps

  1. Follow the steps in Create a Submittal.
    This reveals the New Submittal page.

  2. Scroll down to the Submittal Schedule Information area.

  3. Set the following information:

    1. Schedule Task. The schedule task associated with the submittal being created. A schedule must be uploaded to the project first. See Upload a Project Schedule File to Procore's Web Application.

    2. Note: If you enter 7, the system subtracts '7' calendar days from the Planned Return Date to automatically populate the date entry for the Planned Internal Review Completed Date.

    3. Note: If you enter 10, the system subtracts '10' calendar days from the Required On-Site Date to automatically populate the date entry for the Planned Return Date.

    4. Note: If you enter 5, the system subtracts '5' calendar days from the Planned Internal Review Completed Date to automatically populate the date entry for the Planned Submit by Date.

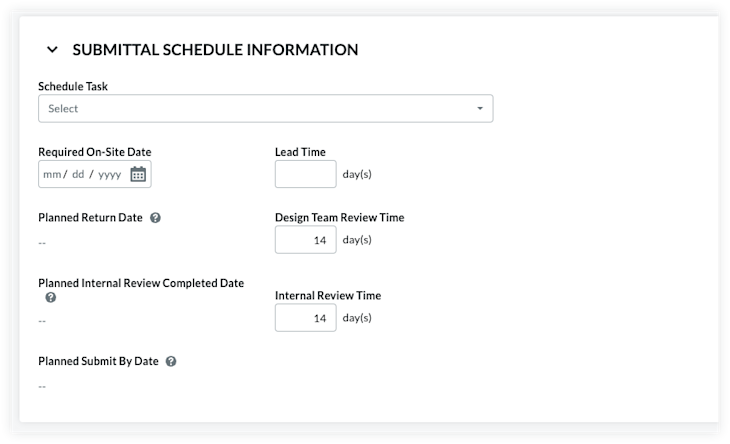

      This illustration shows you an example of these entries and calculations.
