Which data columns are in a Field Production Report?

Note icon Note

For projects using Procore's Resource Tracking tools under 'Resource Management' who have created custom segment objects in Procore's Work Breakdown Structure, please be aware that the custom segment objects are not yet supported in Procore's Resource Tracking tools. To learn more, see Are custom segments compatible with Procore's Resource Tracking tools?

Answer

The Field Production Report provides Procore users with the ability to compare a construction project's budgeted production quantities with its installed production quantities. With the appropriate permissions, you can view this report with the project's 360 Reporting or Timesheets tool. See View a Field Production Report.

Note icon Notes
Example icon

Field Production Report Columns

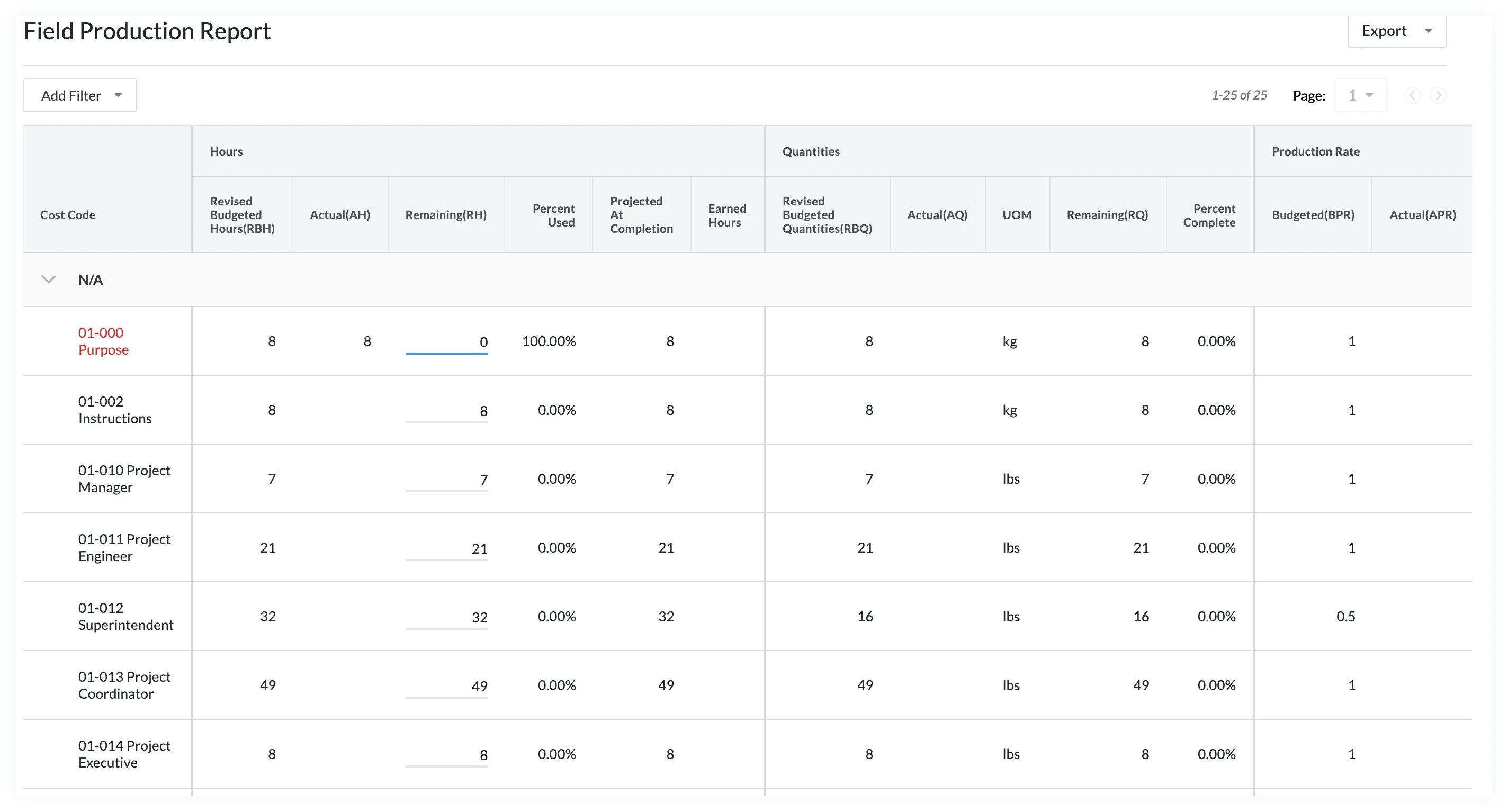

The following image shows you a Field Production Report.


The following table details the report columns in the 'Field Production Report.' It also details how calculation and configured in each column. You cannot customize the columns in this report.

Report Section

Column Name

Column Type

Column Format

Column Description

Column Configuration

Hours

Revised Budgeted Hours (RBH)

Source

Number

Shows the budgeted number of hours for the cost code.

-

Actual (AH)

Source

Number

Shows the actual number of hours entered to date for the cost code.

-

Remaining Hours (RH)

Calculated

Number

Shows the remaining number of hours for the cost code.

Budgeted Hours subtract (-) Actual Hours

Percent Used

Calculated

Percentage

Shows how much of the current budget unit qty (labor hours) have been used based on time submitted in Procore.

Timesheet Hours divide (/) Revised Budget Unit Qty

Projected At Completion

Calculated

Currency

Shows the estimated labor hours needed to complete production for the cost code based on the work produced to date.

(Remaining Qty divide (/) Actual Production Rate) add (+) Actual Hours

Earned Hours 1

Calculated

Number

Shows the number of labor hours earned (merited) based on the work produced to date for that cost code.

(Budgeted Hours multiply (*) Actual Qty) divide (/) Revised Budgeted Qty

Quantities

Revised Budgeted Quantities (RBQ)1

Source

Number

Shows the budgeted production quantity for the cost code.

-

Actual (AQ)

Source

Number

Shows the actual production quantity to date for the cost code.

-

UOM

Source

n/a

Shows the UOM for the cost code

Source Category: Production UOM Source: Budgeted Production UOM Source Filtering: n/a

Remaining (RQ)

Calculated

Number

Shows the remaining production quantity for the cost code.

Budgeted Production Qty minus (-) Remaining Production Qty

Percent Complete

Calculated

Percentage

Shows the percentage of the production quantity has been installed to date of the current budgeted production quantity for the cost code.

Actual Qty Installed divide (/) Revised Budgeted Production Qty

Production Rate

Budgeted (BPR) 1

Calculated

Number

Calculates the production rate based on the budgeted number of hours and budgeted quantities.

Budgeted Production Qty divide (/) Revised Budgeted Hours

Actual (APR)

Calculated

Number

Calculates the actual production rate based on the actual number of hours and installed production quantities updated in Procore to date.

Actual Qty Installed divide (/) Actual Hours

Variance

Calculated

Number

Calculates the difference the actual and budgeted production rate.

Actual Production Rate minus (-) Budgeted Production Rate

1 If the project has any change orders in the 'Approved' status, the 'Budgeted (BQ)' column label changes to 'Revised Budgeted (RBQ)'. In addition, the RBQ is used to calculate the values in the Budgeted Production Rate (BPR) and Earned Hours columns.
